Page 63 - Industrial Plants
P. 63

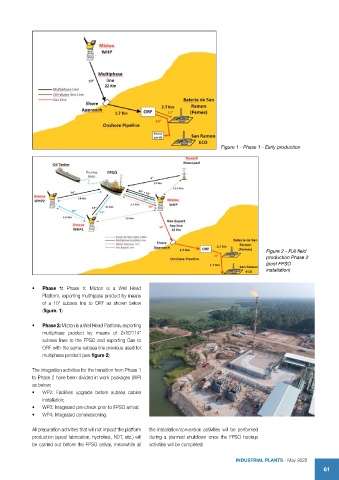

Figure 1 - Phase 1 - Early production
Figure 2 - Full field
production Phase 2
(post FPSO
installation)
• Phase 1: Phase 1: Mizton is a Well Head
Platform, exporting multhipase product by means
of a 10” subsea line to ORF as shown below
(figure. 1)
• Phase 2: Mizton is a Well Head Platform, exporting
multiphase product by means of 2x10”/14”
subsea lines to the FPSO and exporting Gas to
ORF with the same subsea line previous used for
multiphase product (see figure 2).
The integration activities for the transition from Phase 1
to Phase 2 have been divided in work packages (WP)
as below:
• WP2: Facilities upgrade before subsea cables
installation;
• WP3: Integrated pre-check prior to FPSO arrival;
• WP4: Integrated commissioning.
All preparation activities that will not impact the platform the installation/conversion activities will be performed
production (spool fabrication, hydrotest, NDT, etc.) will during a planned shutdown once the FPSO hookup
be carried out before the FPSO arrival, meanwhile all activities will be completed
IndustrIal Plants - May 2022
